why the project supply can't supply to no project demand of some item but some item can?

edited Jun 17, 2025 1:27PM in Discrete Manufacturing - EBS (MOSC) 3 commentsAnswered
  1. MPR plan option

Reservation Level : Planning Group;

hard pegging level: Project;

2. item plan attribute: End Assembly/ Hard Pegging

3. MRP result

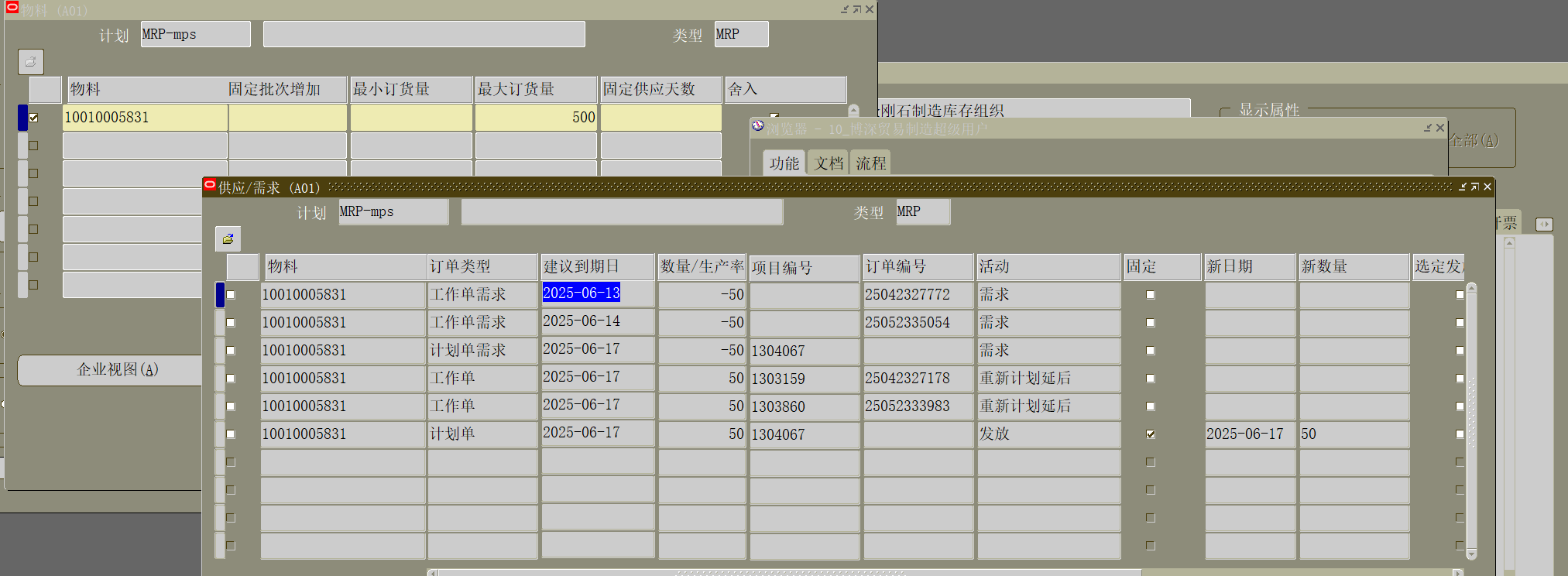

10010005831 , project supply can supply to no project demand,Release new plan order with Project。

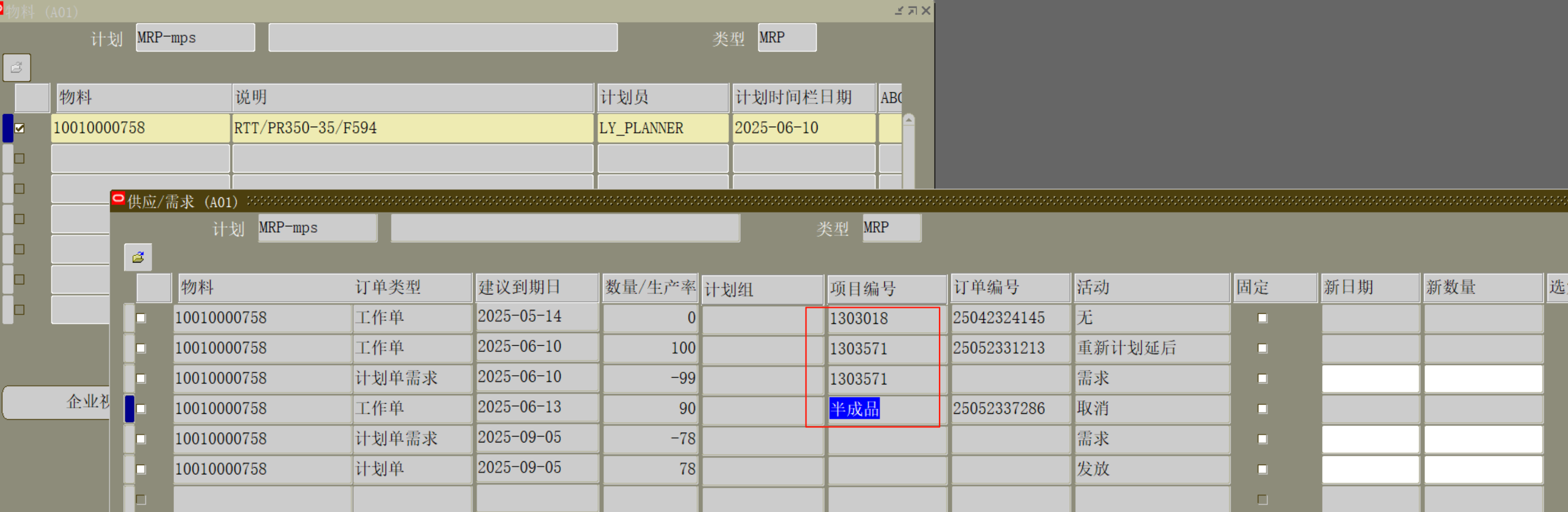

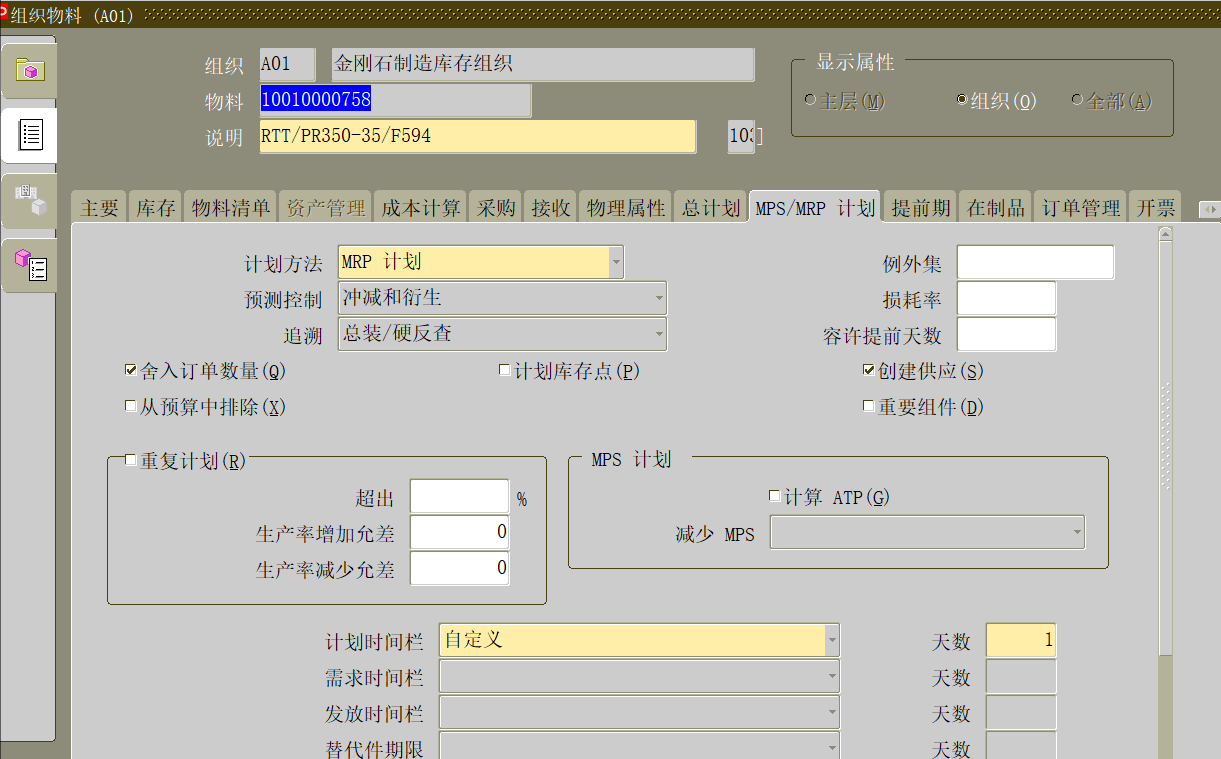

10010000758,MRP give "cancelled" suggestion for 90 work order project supply, again give release new plan order 78,why 90 project supply can't supply to 78 plan order demand and should give 'Revised schedule postponed' suggestion for 90 ;

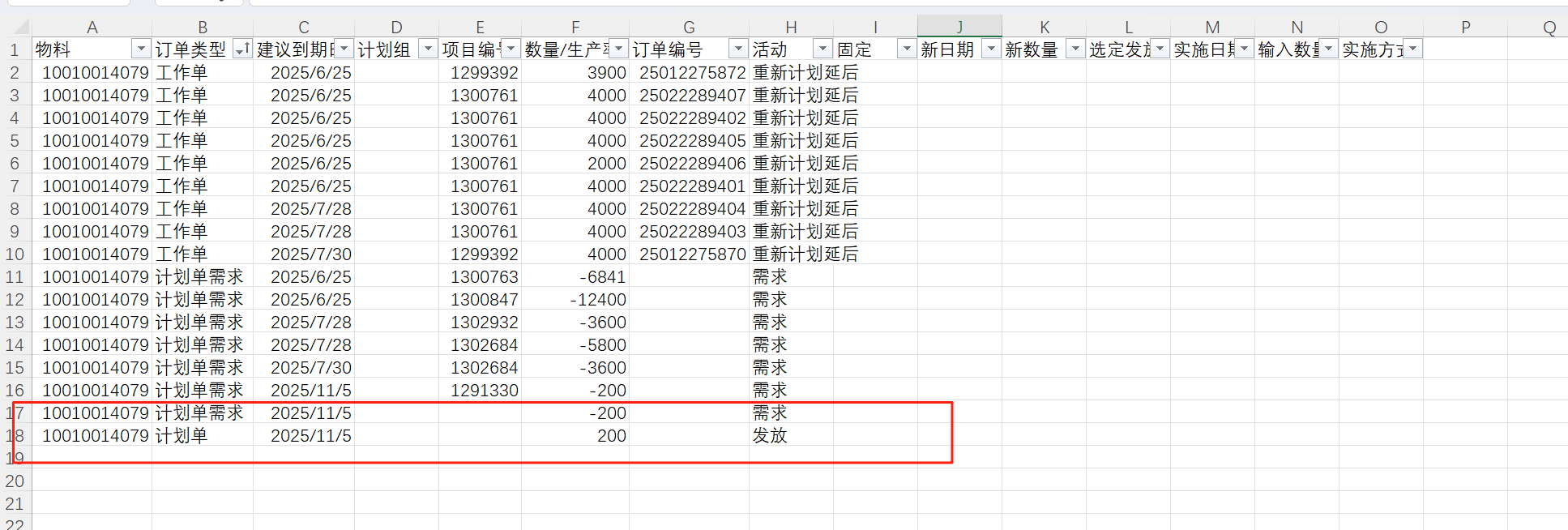

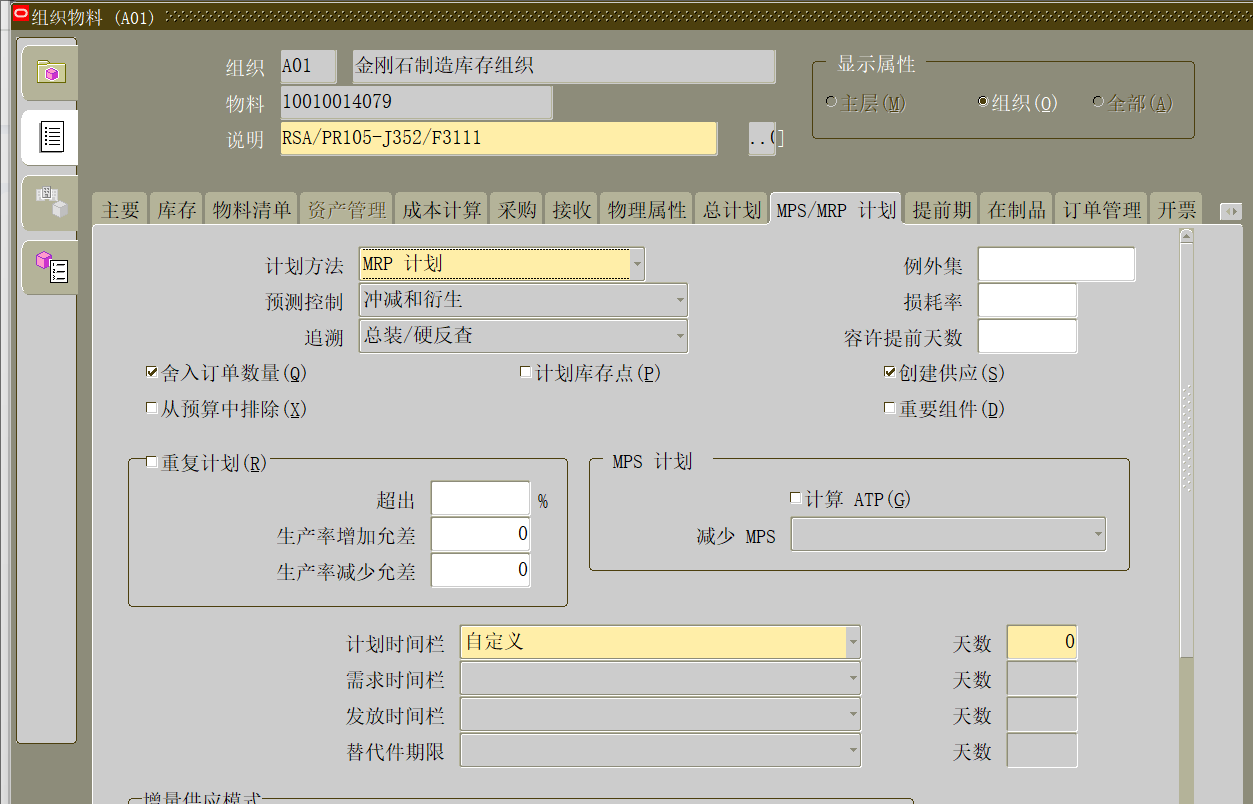

10010014079, all project supply is 33900 which greater than the total quantities of project demand and no project demand ,why MRP also give release plan order for 200 plan order demand on 2025-11-05??

Howdy, Stranger!

Log In

To view full details, sign in to My Oracle Support Community.

Register

Don't have a My Oracle Support Community account? Click here to get started.

Category Leaderboard

Top contributors this month

New to My Oracle Support Community? Visit our Welcome Center

MOSC Help Center
